Timeline

January 2023

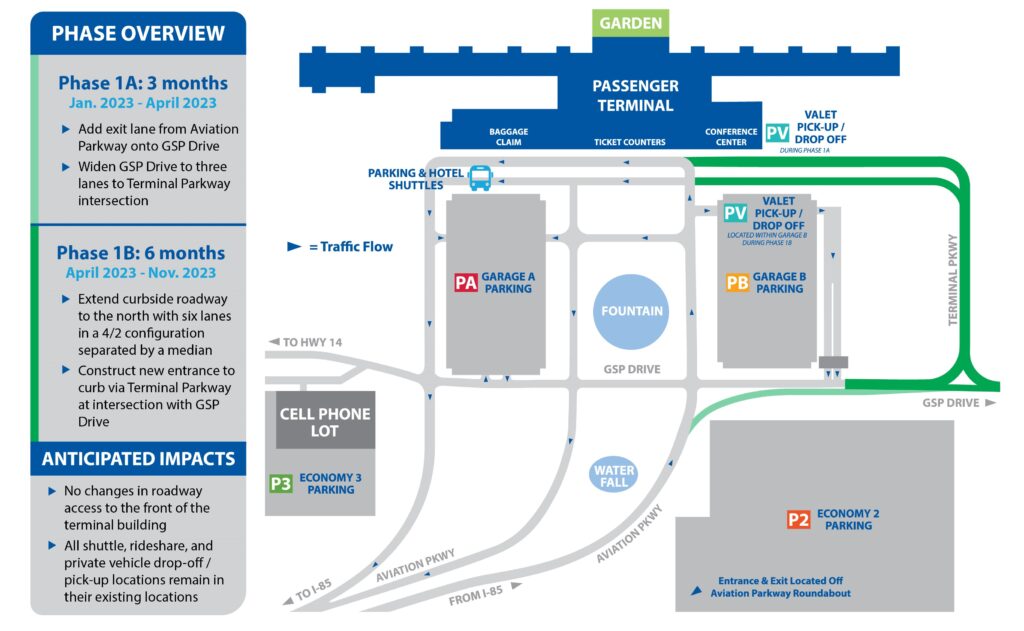

Phase 1A

  • Construct a slip lane from in-bound Aviation Parkway to GSP Drive.
  • Widen GSP Drive to three lanes up to the Terminal Parkway intersection.
  • Construct a temporary access road from GSP Drive to the Airport Operations and Badging parking lot.
  • Construct a temporary access road from GSP Drive to the employee parking lot.

Duration: Approximately 3 months.

January 2023
April 2023

Phase 1B

  • Extend curbside roadway to the north with six lanes in a 4/2 configuration separated by a median.
  • Construct new entrance to curb via Terminal Parkway at intersection with GSP Drive.
  • Periodic lane closures and active traffic control can be expected on GSP Drive.
  • Passengers will be routed to the terminal via GSP Drive and Terminal Parkway.
  • Valet Parking will be temporarily relocated to Parking Garage B (PB).
  • A new pedestrian crossing will be constructed between Garage B (PB) and the terminal.

Duration: Approximately 4 months.

April 2023
December 2023

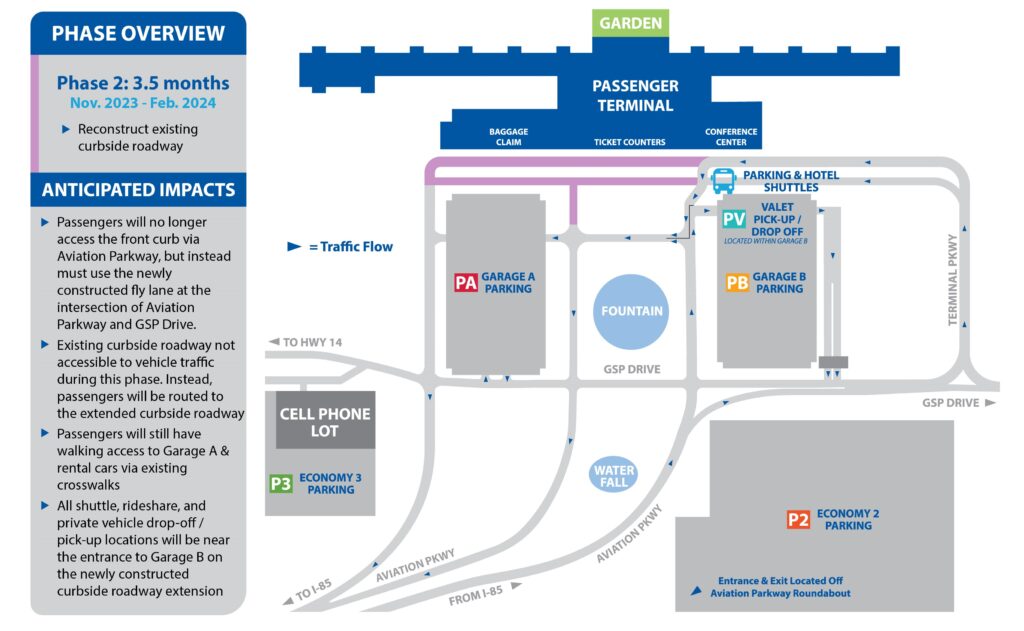

Phase 2

  • Reconstruct existing curbside roadway.
  • All lanes of the expanded curb front to the north will be utilized for passenger drop-off and pick-up with traffic exiting at the southeast corner of Parking Garage B.
  • Vehicle access to and from the Parking Garages will remain unchanged.
  • Valet operations will remain in Garage B.
  • Pedestrian access to the terminal will utilize the crosswalks from Garages A and B.
  • A protected pathway for pedestrian access across the Garage A crosswalk will be maintained at all times during the construction of this phase.

Duration: Approximately 3.5 months.

December 2023
March 2024

Phase 3A

  • Construct two new roundabouts on GSP Drive, adjusting intersection roadways to match curvature of roundabouts.
  • Passengers will be routed to the curb front as the previous phase.
  • All lanes of the curb front roadway will be utilized for passenger drop-off and pick-up.
  • Access to and from the Parking Garages will be via northern roundabout.
  • Valet operations will be return to the curb front.
  • Pedestrian access to the terminal will utilize the crosswalks from Garages A and B.

Duration: Approximately 7 months.

March 2024
July 2024

Phase3B

  • Reconstruct GSP Drive approach to northern roundabout.
  • Passengers will be routed to the curb front as the previous phase.
  • All lanes of the curb front roadway will be utilized for passenger drop-off and pick-up.
  • Access to and from the Parking Garages will be via northern roundabout.
  • Valet operations remain at the curb.
  • Pedestrian access to the terminal will utilize the crosswalks from Garages A and B.

Duration: Approximately 5 months.

July 2024

Frequently Asked Questions

During phase 1, passenger drop-off and pick-up will remain in its existing location while the curb extension is constructed. During phase 2, all passenger drop-off and pick-up will be shifted north onto the newly-constructed curb extension, which can be accessed via Terminal Parkway. During Phase 3, both the existing curbside roadway and the extended section will be complete and thus passenger drop-off and pick-up will resume along the entirety of the curb.

For Garages (A & B) and Economy Lots (P1, P2, P3), there will be no changes to the entrances and exits throughout the project. However, during Phase 3, vehicles will travel through a dedicated lane across construction at GSP Drive/Aviation Parkway to reach Garage A & B. Additionally, Valet parking will move locations during the project. During Phase 1A, Valet drop-off & pick-up will remain in its existing location adjacent to Garage B. Beginning during Phase 1B, Valet pick-up & drop-off will move into Garage B and will remain there until the end of Phase 2. Valet will move back to its original location on the curb during Phase 3.

During phase 1, all shuttle and rideshare drop-off and pick-up will remain in its existing location near baggage claim while the curb extension is constructed. During phase 2, all shuttle and rideshare drop-off and pick-up will be shifted north onto the newly-constructed curb extension, which can be accessed via Terminal Parkway. During Phase 3, both the existing curbside roadway and the extended section will be complete and thus all shuttle and rideshare drop-off and pick-up will resume in their original locations near baggage claim.

During Phase 1A, Valet drop-off & pick-up will remain in its existing location adjacent to Garage B. Beginning during Phase 1B, Valet pick-up & drop-off will move into Garage B and will remain there until the end of Phase 2. Valet will move back to its original location on the curb during Phase 3.

To better prepare yourself for any delays around construction, we recommend arriving 2 hours prior to your flight’s departure time.

During the Terminal Roadway Improvement Project (TRIP), it is necessary to remove some trees along the roadways at GSP. The trees are being removed to make way for roadway improvements ro reduce congestion near the terminal. Once this project is complete, we will replace these trees with new trees that will allow GSP to continue to offer our airport’s unique park-like environment for many years to come.

Please call our Information Center at 864-877-7426 or text us at 864-485-8885.
